Enshi Tangkou — 4 × 11 MW modernisation

Four 11 MW units at a state power group plant in Hubei, China, upgraded with oil-free blade pitch control and modern governor systems — a control-system retrofit programme planned around the plant’s own outage windows.

Version française →
4 × 11 MWunits modernised
Oil-freeblade pitch control
Governor +control modernisation
HubeiChina · state power group plant

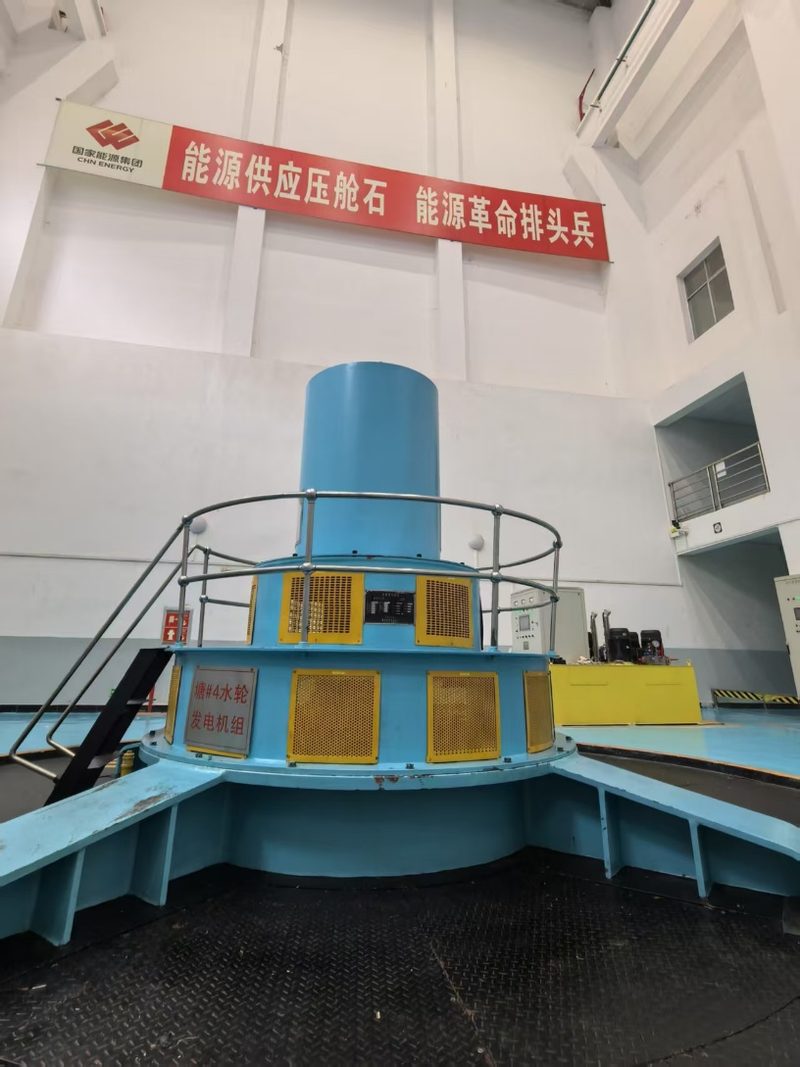

Enshi Tangkou hydropower modernization - turbine hall during the programme

1 The plant

Enshi Tangkou is an 11 MW × 4 unit plant in Enshi, Hubei, operated by a state power group. The units’ original control systems had aged past the point of economic repair: parts availability, control behaviour and maintenance burden all pointed to a modernisation programme rather than another repair cycle.

2 Scope of the retrofit

  • Oil-free blade pitch control systems on all four units. The double-regulated units’ runner blades were re-equipped with oil-free pitch control, removing the oil-filled runner hub entirely.
  • Governor and control modernisation across the four units. New governor hardware and control logic in place of the obsolete systems, integrated with the plant’s existing electrical infrastructure.

3 Why oil-free pitch control

Conventionally, adjustable-blade (Kaplan-type) runners keep an oil-filled hub: the oil transmits pressure to the blade mechanism. That oil is also a permanent liability — hub seals weep, and any leakage ends up in the river. An oil-free hub removes the oil from the equation altogether: no leak risk to the watercourse, and one less fluid system to monitor and maintain.

For plant owners, the practical consequences are environmental compliance and a maintenance schedule with an entire subsystem deleted from it. This is the same oil-free pitch technology we now supply as a product line (OFBP) and apply in retrofit programmes such as this one.

4 How the work was executed

Control retrofits live or die on outage planning. Factory acceptance testing was completed before shipment, so that site time was spent installing and commissioning proven equipment rather than debugging it. Work was organised around the plant’s outage windows, unit by unit, so that the remaining units kept serving the grid while each unit was converted.

Key factDetail
PlantEnshi Tangkou HPP
LocationEnshi, Hubei, China
Units4 × 11 MW
Operator typeState power group
ScopeOil-free blade pitch control + governor and control modernisation
ExecutionFAT before shipment; unit-by-unit around outage windows
StatusCompleted

Tangkou retrofit — FAQ

Can the plant keep generating during a retrofit like this?

Yes, unit by unit. Work is scheduled around the plant’s outage windows so that the units not being converted keep running. Factory acceptance testing before shipment keeps the on-site phase short.

Do you retrofit units you did not manufacture?

Yes. We manufacture retrofit components from drawings, samples or reverse-engineered measurements, including runners, blade mechanisms, governors and control systems, for machines originally supplied by other manufacturers.

What results should we expect from a control modernisation?

It depends on the unit’s condition, which is why every programme starts with an assessment rather than a generic promise. We commit to measured performance after commissioning and to a maintenance schedule you can plan around — not to headline percentages.

Have an ageing unit?

Send us the nameplate data and the problems you are seeing. We will come back with a retrofit view and the closest matching reference — within two working days.

Request a retrofit assessment WhatsApp
More case studies: Sahatona 1.6 MW · Ambatosia 1.7 MW · All case studies · Retrofit guide
Direct: sales@tch-hydro.com · +86 158 7484 2996
24/7 Engineer Chat
售前咨询 / Presales

TCHIER Presales Engineer

Hydropower & Renewable Energy
AI O&M Assistant
🔧

TCH Smart O&M Copilot

Africa Hydro · O&M & Operations
